Rawalpindi Ring Road: Complete Map, Route, Interchanges & Latest Updates (2026)

What Is the Rawalpindi Ring Road?

Rawalpindi Ring Road, or RRR is a six-lane, controlled-access highway stretching 38.3 kilometres starting at Baanth on GT Road (N-5) near Rawat and ending close to the M-2 Motorway, over by Thalian. Now, here’s a detail that trips a lot of people up: the name suggests it wraps all the way around the city, but it doesn’t. This is a straight bypass corridor, not a ring in the literal sense. There was actually a much more ambitious version planned years ago — a loop running 65 to 68 kilometres that would’ve curved back and tied into Islamabad’s Margalla Highway. That version never made it off the drawing board.

Two organisations are behind the build: the Rawalpindi Development Authority (RDA) is overseeing the project overall, and the actual construction work is being handled by the Frontier Works Organization (FWO).

DetailFigure
Length38.3 km
Lanes6 (controlled access)
Interchanges5
Speed limit120 km/h
Estimated cost~Rs. 47 billion (core road); ~Rs. 51–52 billion including Thalian interchange
Executing agencyRDA
ContractorFWO
Expected daily traffic30,000+ vehicles

Why the Ring Road Was Planned

Anyone who’s driven through Murree Road or Saddar during peak hours knows the problem firsthand. These roads were built for local traffic, not for the long-haul freight trucks that pass through Rawalpindi on their way between Peshawar and Islamabad. That mismatch is exactly what pushed the idea forward. It’s not new, either — the concept of bypassing the city goes back to 1991, under Nawaz Sharif’s government. It resurfaced in 2010 during funding talks with China, got pitched to the Asian Development Bank in 2017, and finally had a proper PC-1 feasibility study done in 2018.

Strip away the politics and the delays, and the problem is simple: heavy vehicles have been cutting straight through an already congested city. Once the road is fully operational, officials are projecting that it’ll pull 25 to 30 percent of general traffic off the city’s roads, along with roughly 70 percent of heavy goods transport.


Current Project Status (as of July 2026)

Construction had stalled for a while over redesign issues, but it picked back up in September 2023, and the last few months have seen real momentum.

Asphalt work now covers the entire 38.3 km stretch — that part’s done. Four of the five interchanges are either finished or nearly there: Baanth, Chak Beli Khan (also called Maira Mohra), Adiala Road (Khasala), and Chakri Road (Kolian Parr). The fifth, Thalian, has been pushed to a later phase — for now, a temporary two-way carriageway is handling the motorway connection instead.

What’s left is mostly finishing touches: lane markings, drainage, fencing, landscaping, signboards, and getting the lampposts and lighting installed, which officials expect to wrap up within weeks. As for handover, project officials said they’d formally report the road complete to the Punjab government in the first week of July 2026, after which an inauguration date will be announced.

One thing worth being upfront about: nobody has confirmed an exact public opening date yet. The Punjab government, under Chief Minister Maryam Nawaz, is expected to lock in that date once the handover paperwork goes through — but nothing’s official yet. So if you come across a specific opening date somewhere online, take it with a pinch of salt until it’s actually confirmed by the government.

Key Takeaways

  • The main corridor is essentially done, with only cosmetic and safety work left.
  • Thalian won’t be part of the initial opening — that’s a phase-two item.
  • Once the road opens, expect a toll system modeled on the one already running on the Lahore Ring Road.

Latest Updates

On July 1, 2026, NESPAK wrapped up its Phase II feasibility study and came back with a recommendation to widen the existing M-2 Motorway — adding two lanes on each side — rather than build an entirely new alignment from Thalian to Sangjani. It’s the cheaper, faster path to extending connectivity toward Islamabad.

A few days before that, on June 28, Deputy Project Director Ashfaq Sulheri confirmed the asphalt work was done across the full 38.3 km, with only finishing tasks left. Back in May, the Rs. 4.8 billion PC-1 for the Thalian Interchange got approved, which confirmed it’ll move forward as its own separate follow-up project. And in April, the Punjab government made the call to open the main road using a temporary Thalian connection instead of holding up the whole project waiting for it.

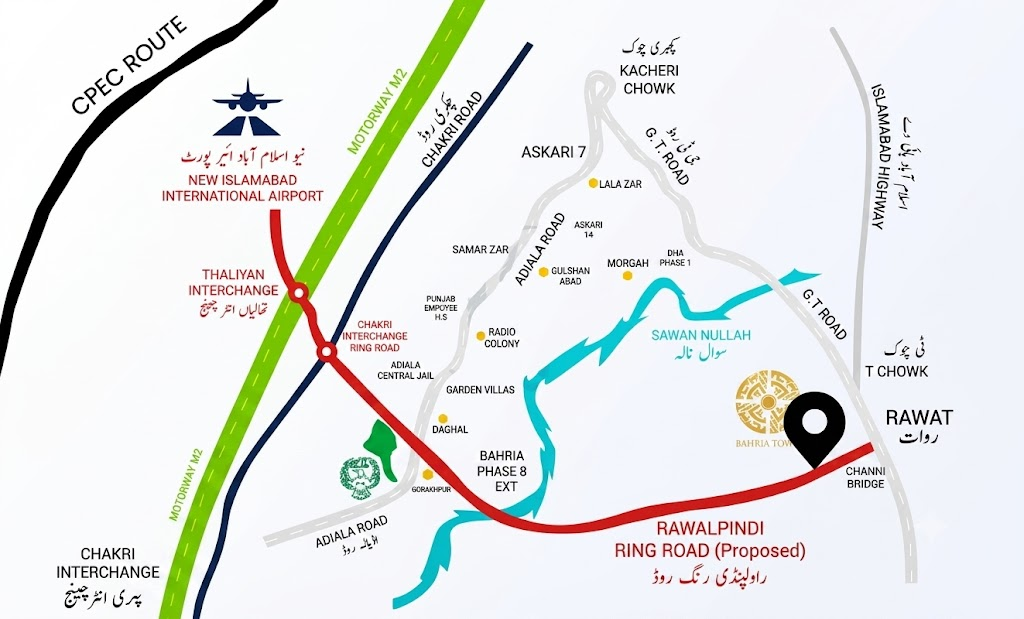

Rawalpindi Ring Road Map & Route Overview

rawalpindi ring road

Complete Route Description

You can approach the Ring Road from either end — it runs west to east or east to west, depending on where you’re coming from — and it cuts across Rawalpindi’s outskirts, linking GT Road with the motorway network on the other side:

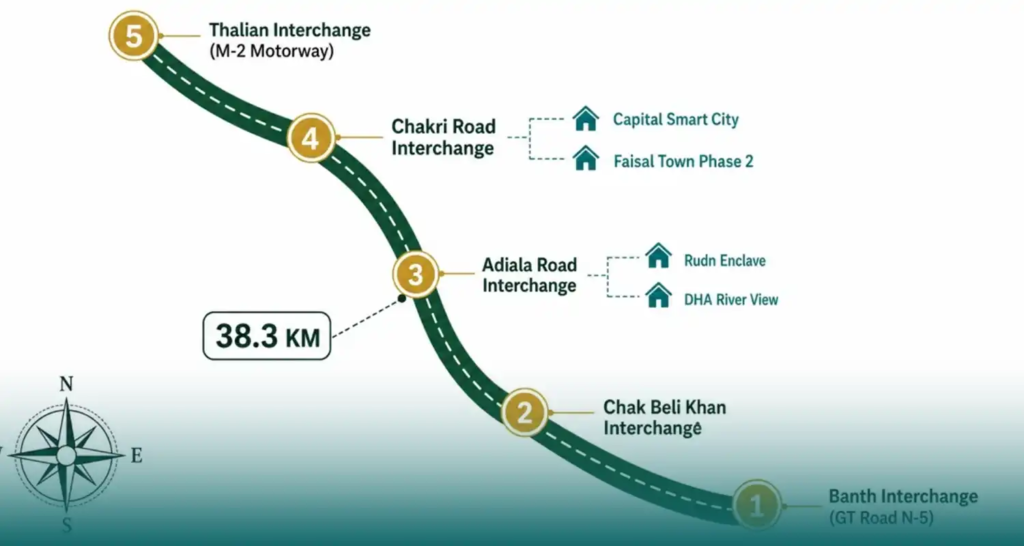

Baanth (GT Road, N-5, near Rawat) → Chak Beli Khan / Maira Mohra → Adiala Road / Khasala → Chakri Road / Kolian Parr → Thalian (M-2 Motorway)

Different sources use either the road name (Adiala Road, Chakri Road) or the local place name (Khasala, Kolian Parr) for the same interchange — both refer to the same physical points.

Nearby Housing Societies

DHA Gandhara Islamabad tops the list, sitting right in line to take direct benefit from the Ring Road once it’s operational. Beyond that, Rudn Enclave sits closest to the Adiala Road and Chakri interchanges, Capital Smart City connects via Chakri Road and the M-2 Motorway, and Blue World City runs along Chakri Road as well. Bahria Town, including its Phase 8 and later extensions, ties into the Adiala Road interchange, while Top City, Mumtaz City, and Nova City all cluster around the Chakri Road corridor. Kingdom Valley also falls within that same Chakri Road stretch, and University Town connects mainly through the airport corridor near Thalian.

A word of caution: Real estate marketing often overstates “direct access.” Always verify a society’s actual distance to the nearest interchange and its NOC status independently before treating Ring Road proximity as a guaranteed value.

Rawalpindi Ring Road Interchanges

InterchangeConnects ToStatus (mid-2026)
BaanthGT Road (N-5), RawatComplete
Chak Beli Khan (Maira Mohra)Chak Beli Khan RoadComplete/near-complete
Adiala Road (Khasala)Adiala Road, Rudn Enclave, Bahria Town Phase 8Complete/near-complete
Chakri Road (Kolian Parr)Chakri Road, Blue World City, Capital Smart City areaComplete/near-complete
ThalianM-2 Motorway, New Islamabad International AirportDeferred — temporary link in use

Route from Rawat

Rawat marks the eastern starting point, close to the Baanth Interchange on GT Road. This is the natural entry point for traffic arriving from the Peshawar direction, GT Road, or from within Rawalpindi’s eastern suburbs.

Banth Interchange

The Baanth Interchange is the project’s anchor point on GT Road. Officials have said this will serve as the primary entry/exit for traffic once the road opens, since Thalian isn’t ready yet.

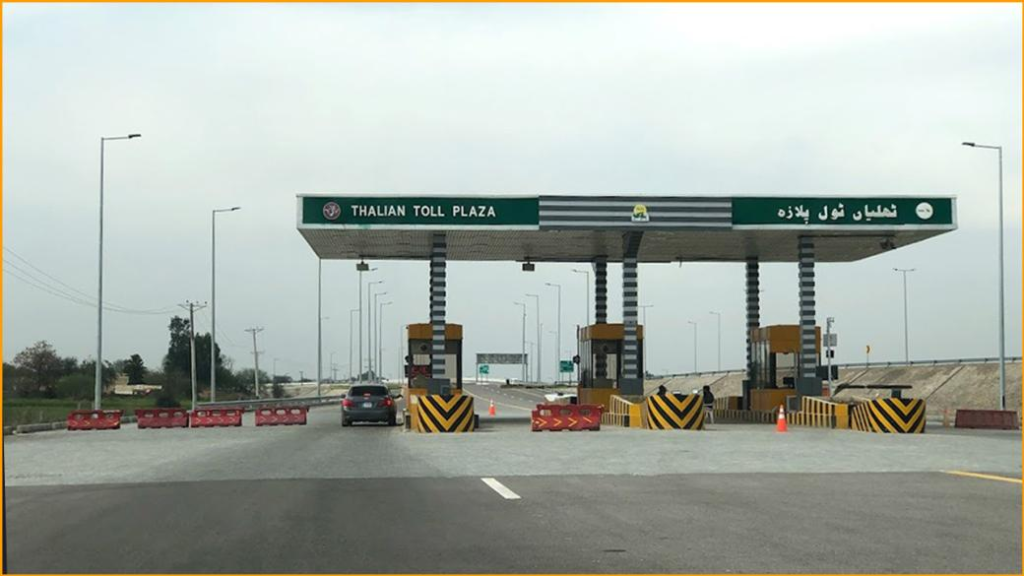

Thalian Interchange

rawalpindi ring road

Thalian is the western terminus, meant to connect the Ring Road directly to the M-2 Motorway and, from there, the New Islamabad International Airport. Its construction — including a widened design to handle a projected 18,000+ vehicles merging onto the motorway — has been pushed to a second phase, expected to take around three months once it starts.

Connection with M-1, M-2, GT Road, and CPEC Routes

  • M-1 Motorway: Linked indirectly through the wider motorway network once Thalian is complete.
  • M-2 Motorway: Direct connection at Thalian, Lahore–Islamabad Motorway.
  • GT Road (N-5): Direct connection at Baanth.
  • CPEC route relevance: There’s also a CPEC angle worth mentioning — the corridor plugs into the larger logistics network that handles CPEC-related freight moving between Punjab and the north.

Connection with Islamabad

The Ring Road doesn’t run through Islamabad itself, but it connects to routes (via M-2 and Chakri Road) that lead into Islamabad’s western sectors and the airport zone — which is why it frequently appears in searches as “Islamabad Ring Road” even though it’s primarily a Rawalpindi-side project. Rawalpindi Ring Road is also important for DHA Gandhara

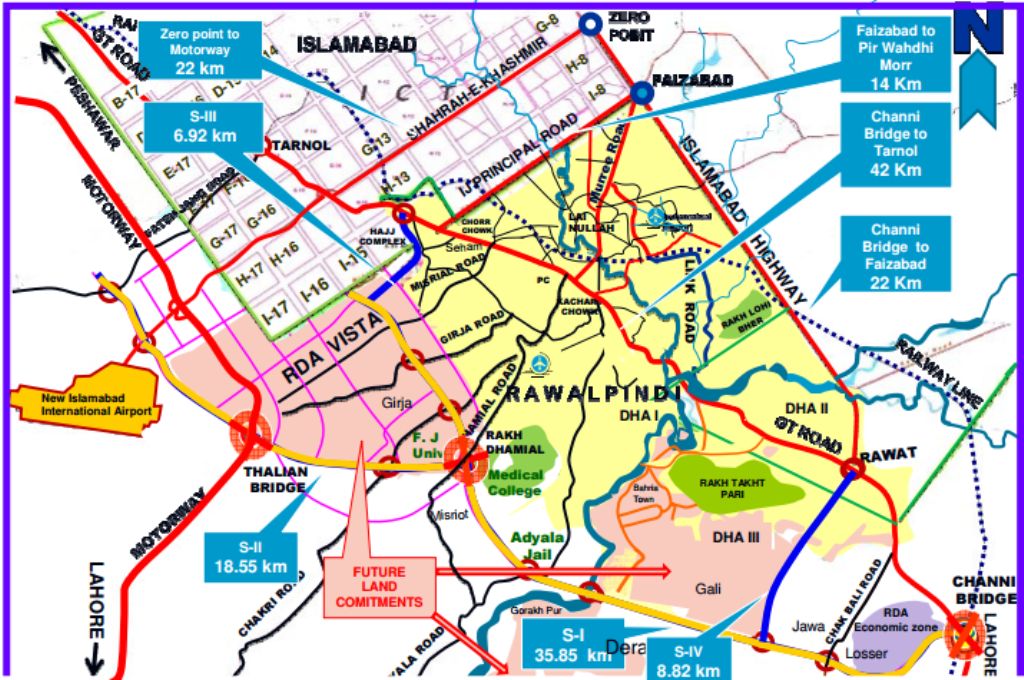

Ring Road Map

Can users download an official map? As of this writing, RDA has not published a downloadable official PDF map for general public download. Several unofficial and real estate–sourced maps circulate online; treat these as approximations rather than engineering drawings. If an official PDF is released, it would most likely be hosted on RDA’s own website.

rawalpindi ring road map

Where to look: Your best bet is sticking to RDA’s own official channels and trustworthy local news sources — most of the maps floating around elsewhere online are generic third-party guesses, not the real thing.


Project Timeline, Cost & Progress

MetricDetail
Foundation stone laidMarch 2022
Construction restartSeptember 2023
Asphalt work completedJune 2026
Expected handover to the Punjab govtFirst week of July 2026
Formal inaugurationPending official announcement
Length38.3 km
Lanes6
Estimated cost (core project)~Rs. 47 billion
Thalian Interchange (separate PC-1)~Rs. 4.8–5 billion
Combined total~Rs. 51–52 billion

Did You Know? The project cost has climbed from an original estimate of roughly Rs. 33 billion to over Rs. 47 billion, largely due to inflation in construction materials and added scope like the Thalian upgrade.

Traffic & Economic Benefits

The most immediate benefit is decongestion — freight and through-traffic get pulled away from Murree Road, Saddar, and the inner stretch of GT Road. With a 120 km/h design speed, commute times should drop noticeably compared to what you’d deal with on city roads. On the freight side, around 70 percent of heavy goods traffic is expected to shift over to the new corridor. There’s an economic angle too: a planned industrial zone along the route is meant to draw in logistics and manufacturing investment. Islamabad stands to gain better airport access once the Thalian phase is done, while Rawalpindi should see less truck traffic clogging its inner roads — which, in turn, could mean better air quality and safer streets.

Future Expansion Plans

There’s also a fresh recommendation on the table from NESPAK’s July 2026 feasibility study — instead of laying down a brand-new road from Thalian to Sangjani, they’re suggesting the government simply widen the existing M-2 Motorway by adding two lanes on either side. It’s a cheaper, quicker fix. But nothing’s locked in — the proposal still has to go through the Punjab government for approval, so treat it as an idea being considered rather than something that’s already decided.

Frequently Asked Questions

What is the length of the Rawalpindi Ring Road? It runs 38.3 kilometres, from Baanth on GT Road to Thalian near the M-2 Motorway.

How many interchanges does it have? Five in total — Baanth, Chak Beli Khan, Adiala Road, Chakri Road, and Thalian.

When will the Rawalpindi Ring Road open? The asphalt work was finished by late June 2026, and handover to the Punjab government was expected in early July. The exact public opening date, though, comes down to whenever the government makes its formal inauguration announcement.

Is the Thalian Interchange finished? No. It’s been pushed to a second phase and will run on a temporary motorway link in the meantime.

What is the project cost? Roughly Rs. 47 billion for the core road, rising to around Rs. 51–52 billion once the Thalian Interchange is factored in.

Is there a toll on the Ring Road? Yes — expect a toll system similar to what’s already running on the Lahore Ring Road once this one opens.

Does the Ring Road connect to Islamabad directly? Not straight through the city, no. But via the M-2 Motorway and Chakri Road, it links into routes that reach Islamabad and the airport.


Conclusion

What started out as a decades-old proposal has quietly turned into a nearly finished, 38.3-km highway — the main carriageway is paved, and four out of five interchanges are done. What’s left is largely finishing work and the Thalian Interchange, which has been pushed to a second phase. An official opening date is still pending confirmation from the Punjab government — everything else, from the route to the interchange layout, is now settled and verifiable. Bookmark this guide; it will be updated as the inauguration date and Thalian Interchange progress are officially confirmed.
